HMP Belmarsh West Prison

SECTOR
Civil Engineering, Groundworks
OUR ROLE
Subcontractor
LOCATION
Belmarsh, London
CLIENT
Skanska / Serco
PROJECT VALUE
£7.5m
DURATION
18 months

OVERVIEW

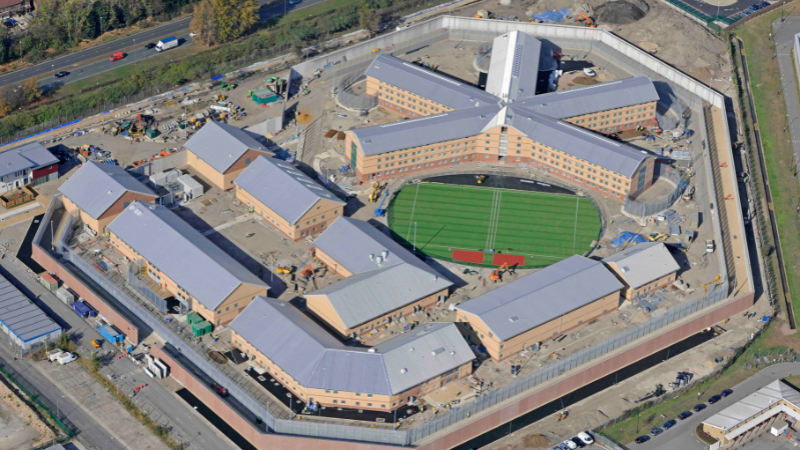

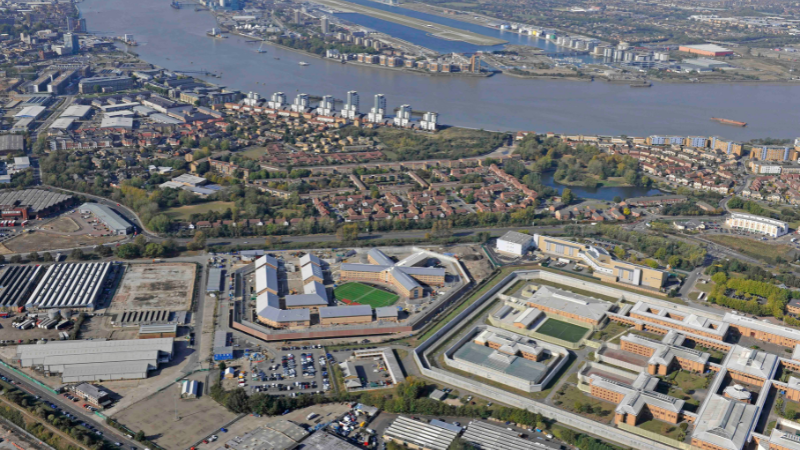

Skanska, working with Serco, have undertaken the design and construction of a new prison at Belmarsh West. The new prison is centred around a 600-cell four-storey house block, along with associated buildings to provide: education, rehabilitation, training, hospital, sports, healthcare, worship, kitchens, recycling, storage, visiting, administration works, horticulture and security. The Natta contract comprises all enabling, associated ground and external works for the complete new 900-inmate prison with an overall value of £7.5 m.

SCOPE OF WORKS

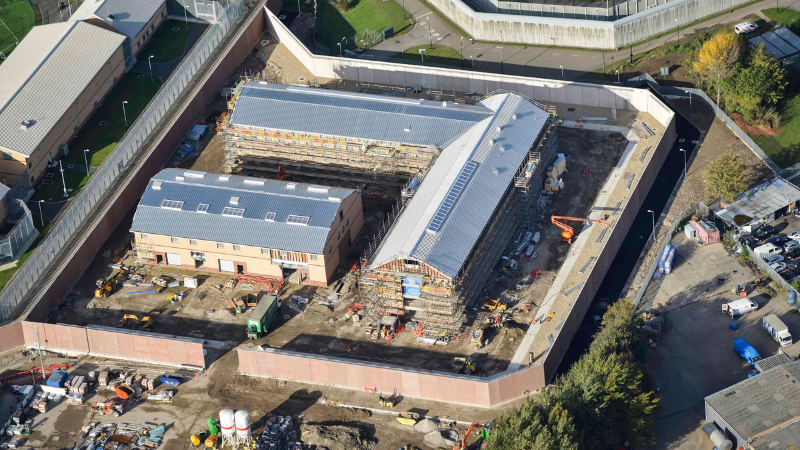

The site was remediated by use of the ‘Conform’ remediation system, the brownfield site being formerly a munitions works for the Woolwich Arsenal. This remediated platform became the working platform for all the following site works. The Natta package includes Surface & Foul Drainage, including a large diameter precast concrete attenuating surface water system, and diversion of the existing prison’s foul pumping main. Ground beams, lift pits, pile caps, Ground floor slabs and general foundation works following the installation of the piling.

The site demanded extensive and complex service installation, including gas, water, communications, and security installed in a very large number of ducts, closely coordinated between the shallow and deep drainage. A high water table combined with poor ground conditions (underlying peat) required extensive use of temporary works, together with complex drainage design solutions. Natta also partnered with Buchan Precast Ltd to carry out the Perimeter Wall works.

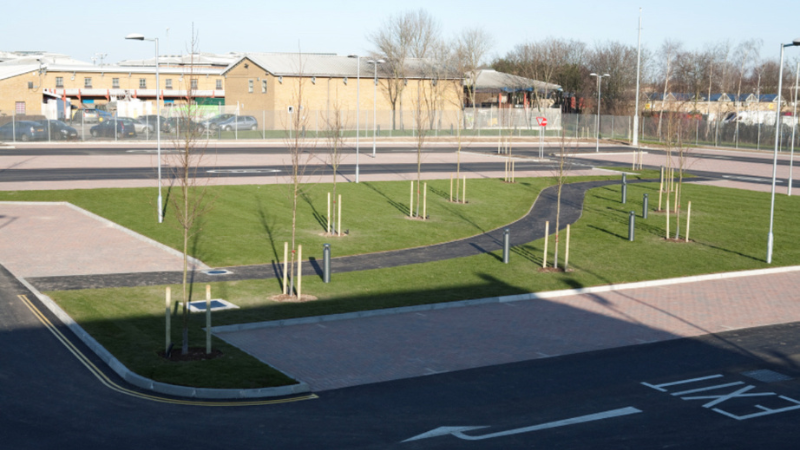

A fast cyclic programme was required to enable Buchans to rotate their temporary propping equipment, while keeping their propping equipment to a minimum and maintaining a fast erect/ cast cycle. Natta trialled and purchased a machine laser from Scan Laser to ensure the 360º machine could be kept digging at full capacity to aid programme requirements. The ‘externals’ outside the wall works include ‘Bodpave’ access road system to the wall perimeter, visitor and main car park, access roads, extensive landscape bunding and surface water ‘Swale’, underground fuel tanks, Grease and Petrol Interceptors. A buried Asbestos treatment programme was also carried out. Specialist Contractor Metro Ltd were engaged to carry this out on our behalf.

Natta Building GDRP Logos
Privacy Overview

This website uses cookies so that we can provide you with the best user experience possible. Cookie information is stored in your browser and performs functions such as recognising you when you return to our website and helping our team to understand which sections of the website you find most interesting and useful.

Cookie Policy

If you leave a comment on our site you may opt-in to save your name, email address and website in cookies. These are for your convenience so that you do not have to fill in your details again when you leave another comment. These cookies will last for one year. If you have an account and you log in to this site, we will set a temporary cookie to determine if your browser accepts cookies. This cookie contains no personal data and is discarded when you close your browser. When you log in, we will also set up several cookies to save your login information and your screen display choices. Login cookies last for two days, and screen options cookies last for a year. If you select “Remember Me”, your login will persist for two weeks. If you log out of your account, the login cookies will be removed. If you edit or publish an article, an additional cookie will be saved in your browser. This cookie includes no personal data and simply indicates the post ID of the article you just edited. It expires after 1 day.

Read more - Privacy Policy
